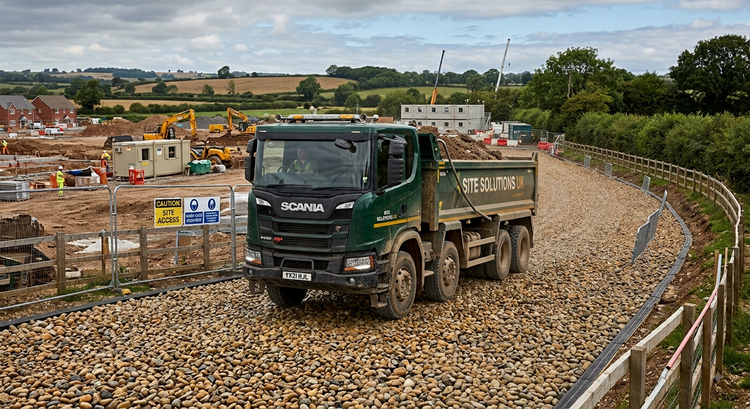

Gravel access tracks reinforced by IBRAN-X50 heavy duty 50mm gravel grids

Gravel Access Roads - Reinforced Farm & Site Tracks

A track that takes the traffic and stays flat. IBRAN grids confine the stone so wheel ruts never start, on farm roads, site access, estate tracks and emergency routes.

Why reinforcement matters here

An access road has a problem a car park does not: every vehicle drives the same line. Wheels track within a few centimetres of each other, day after day, so the load never spreads across the surface. It lands in two narrow channels.

That is why unbound tracks rut so predictably. The stone in the wheel paths is pushed sideways into the crown and the verges, the channels deepen, water collects in them, and the softened ground beneath gives way faster still. Adding more stone treats the symptom for a season.

A cellular grid stops the mechanism rather than the symptom. Each stone is confined in a closed cell, so it cannot be displaced sideways however many times a wheel passes over it. Load transfers down through the aggregate into the ground rather than shunting the aggregate out of the way.

The road stays where you built it, and it drains where it falls rather than channelling water down its own ruts.

Where this works well

  • Farm and agricultural tracks
  • Estate and private roads
  • Construction and site access
  • Forestry and woodland routes
  • Emergency and fire service access
  • Wind farm and utility access tracks
  • Passing places and turning heads
  • Long domestic driveways

At a glance

Sub-base 150-250mm compacted MOT, depending on traffic, vehicle weight and ground conditions
Infill 6-20mm graded blend, angular and clean, filled level plus a 5-10mm blinding
Typical loading Agricultural plant, HGVs, delivery vehicles, emergency appliances
Gradients Confined stone holds on slopes that loose gravel washes off
Drainage Fully permeable. Cross-falls and interceptor drainage still needed on long runs
Edges Restraint essential. The perimeter of a narrow road is a high proportion of its area
Design life 25 years, subject to documented installation
Material 100% recycled polypropylene, made in the UK

Which grid depth?

The number on a grid is a decision about how deep the confined stone layer is. On an access road, where load is concentrated into two narrow channels rather than spread across a wide surface, that depth is doing more work than it does anywhere else.

  • IBRAN®-X50 is our recommendation for access roads. Channelised traffic, heavy vehicles and long design life all point the same way, and a deeper confined layer spreads load across a wider footprint before it reaches the sub-base.
  • IBRAN®-X40 for lighter tracks: occasional use, cars and light vans rather than plant and HGVs.
  • IBRAN®-X30 where you are surfacing over an existing hard track, or excavation depth is constrained.

If you are between two options on an access road, take the heavier duty one. Closing a road to relay it costs far more than the grid ever did, and on a working site it is not just a cost, it is a stoppage.

Choosing your stone

Use a graded blend of 6-20mm, angular and clean. Most guidance points you at a single size, and a single size leaves voids: uniform stone bridges against itself and never quite packs solid. A blend fills those gaps, because the smaller stone wedges in between the larger.

On a road under channelised traffic that difference compounds. A fully bedded cell puts load through the stone and into the ground beneath. A part-filled cell puts it through the plastic instead, and it does so in the same two lines thousands of times a year.

Ask your merchant for washed graded aggregate, angular rather than rounded. Avoid fines and scalpings: they bind the surface, shed water down the road rather than through it, and take away the permeability that keeps the ground beneath firm.

How it goes in

  1. Set out the route and establish falls before anything else. A road collects water along its whole length, so decide now where that water leaves: a cross-fall to one side, a camber, or interceptor drainage at intervals on a long run.
  2. Excavate to the depth of your sub-base plus the grid depth plus the infill blinding. On agricultural and woodland ground, dig out soft spots rather than bridging over them.
  3. Lay a woven geotextile across the formation, lapping joins by at least 300mm. On soft or wet ground this is doing structural work, not just separation: it stops the sub-base punching down into the subsoil and preserves the depth you have paid for.
  4. Lay and compact the sub-base in 50mm layers. Compacting the full depth in one pass does not work whatever the machine, and on a road the consequence appears exactly where the wheels run.
  5. Blind with a thin layer of grit sand and screed it level.
  6. Push-fit the grids together, working from one edge and staggering the joints across the width. Cut to line at the verges with a jigsaw or fine-tooth saw.
  7. Restrain both edges along the full length. On a three metre wide road the perimeter is a large share of the surface, and an unrestrained edge is where the road starts to spread.
  8. Fill the cells with a 6-20mm graded blend, level plus a 5-10mm blinding, working it in with a stiff brush so no cell is left hollow.

Full step-by-step detail is in our gravel grid installation guide.

Gradients and water

Slopes are where unbound tracks fail first, because gravity and rainfall move loose stone downhill together. Confinement removes that: the stone cannot travel, so a gradient stops being an erosion problem and becomes a traction one, which is a far easier problem to have.

Water still needs managing. A long access road intercepts rainfall across its whole length and, on any slope, becomes the path of least resistance for surface water arriving from the land either side. Permeability handles what falls on the road. It does not handle what runs onto it.

Cross-falls, interceptor drains at intervals, and somewhere for water to discharge are worth designing in from the start. It is considerably cheaper than retrofitting them after the first heavy winter.

Turning heads and passing places

These take the hardest wear on the whole road. A turning head sees steering under load with the vehicle stationary or nearly so, which is the single most destructive thing you can do to a gravel surface: it grinds rather than rolls.

Specify the deeper grid across turning areas and passing places even where the running length uses a shallower one. It is a small proportion of the total area and it is where the road would otherwise fail first.

Get it right first time

The one thing worth knowing: build for the heaviest vehicle, not the usual one.

Access roads are almost always specified against everyday traffic, then asked to carry something considerably heavier: a delivery artic, a slurry tanker, a crane on a one-off lift, a fire appliance on the worst possible day. Those movements do the damage, and they arrive whether the road was designed for them or not.

Work out the heaviest vehicle that could realistically need the route, and build the sub-base and grid depth for that. The extra depth across a track is a modest cost. Rebuilding a road because one vehicle sank into it is not.

Common Questions

Things that frequently come up when carrying out this project.
Why do gravel tracks rut and how do grids stop it?

On an access road every vehicle drives almost the same line, so load lands in two narrow channels rather than spreading across the surface. Stone in the wheel paths is pushed sideways, the channels deepen, water collects in them and the ground beneath softens.

A cellular grid confines each stone in a closed cell so it cannot be displaced sideways however many times a wheel passes. That stops the mechanism rather than treating the symptom.

What grid depth do I need for an access road?

The 50mm grid is our recommendation for access roads. Channelised traffic, heavy vehicles and long design life all point the same way, and a deeper confined layer spreads load across a wider footprint before it reaches the sub-base.

The 40mm suits lighter tracks carrying cars and light vans rather than plant and HGVs.

Will a gravel access road take tractors, HGVs and plant?

Yes, when the sub-base and grid depth are specified for it. Build for the heaviest vehicle that could realistically need the route rather than the everyday traffic.

A delivery artic, a slurry tanker or a fire appliance will arrive whether the road was designed for them or not, and those movements do the damage.

Can you lay a gravel access road on a slope?

Yes, and slopes are where confinement earns its keep. Loose stone washes downhill with every rainfall; confined stone cannot travel.

Water still needs managing separately through cross-falls and interceptor drainage, because a road on a slope becomes the path of least resistance for surface water arriving from the land either side.

What sub-base does an access road need?

150mm to 250mm of compacted MOT depending on traffic, vehicle weight and ground conditions, laid and compacted in 50mm layers.

On soft or wet ground, dig out soft spots rather than bridging over them, and use a woven geotextile across the formation to stop the sub-base punching down into the subsoil.

What size gravel is best for an access road?

A graded blend between 6mm and 20mm, angular and washed. A blend packs tighter than a single size because the smaller stone fills the gaps between the larger, and a fully bedded cell puts load through the stone rather than through the plastic.

Under channelised traffic that difference compounds, because the same two lines take the load thousands of times a year.

Do access roads need edging along the full length?

Yes. On a narrow road the perimeter is a large share of the total surface, and the edges take load that the interlocked field does not.

Without restraint the outer grids lift and the road gradually spreads into the verges. Restrain both edges along the full run.

What about turning heads and passing places?

These take the hardest wear on the whole road. Steering under load with the vehicle nearly stationary grinds rather than rolls, which is the most destructive thing you can do to a gravel surface.

Specify the deeper grid across turning areas and passing places even where the running length uses a shallower one.

How does it compare to a tarmac or concrete track?

Installed cost is typically well below a bound surface over any distance, and there is no resurfacing cycle or crack repair.

It stays permeable, so it does not concentrate run-off at the bottom of the route, and it can be laid in sections as budget allows rather than as one continuous pour.

How much maintenance does a reinforced gravel track need?

Very little. Check levels after the first winter and brush any settled cells back up.

Because the stone is confined there is no annual regrading, no repeated stone deliveries and no filling of potholes, which is the normal maintenance cycle for an unbound track. The grid carries a 25 year warranty subject to documented installation.
